A project has 11 activities with the activities preceding constraints, time estimates and work team requirements as shown



A project has 11 activities with the activities preceding constraints, time estimates and work team requirements as shown

Required:

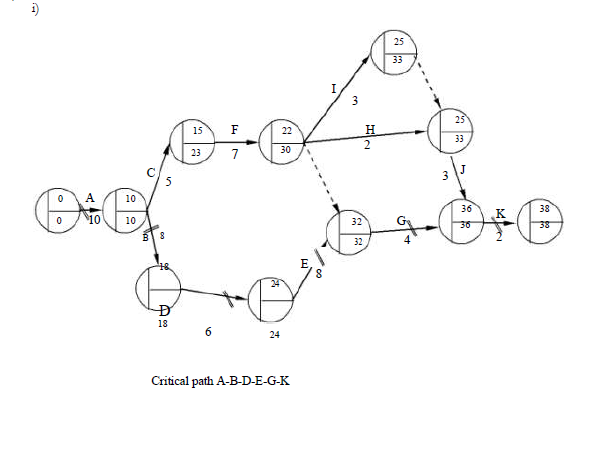

i) Prepare a network and indicate critical path.

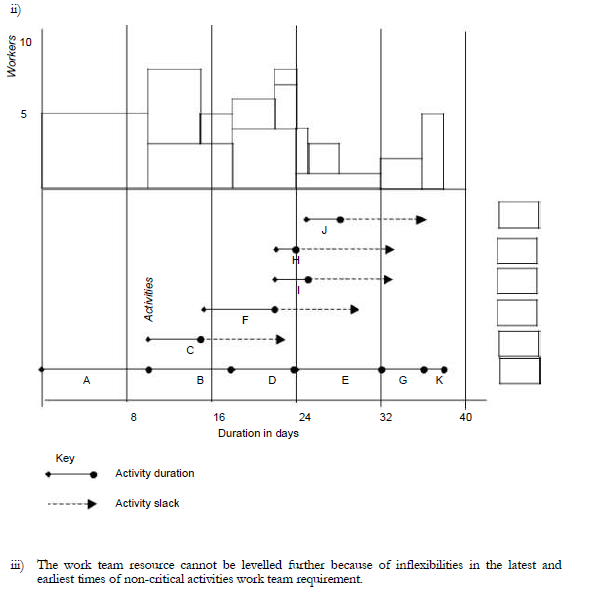

ii) Prepare a time chart and work team requirement.
iii) Can the work team resource be levelled further? Why?



Answers


Wilfred
Wilfykil answered the question on February 20, 2019 at 12:30


Next: In relation to project analysis define the terms: i) Latest start time. ii) Earliest start time. iii) Resource leveling.
Previous: State three methods of presentation during public speaking
