The following is the Trial Balance of Premier Construction Company engaged on the execution of Contract No. 747 for the year ended 31st December, 2010



The following is the Trial Balance of Premier Construction Company engaged on the execution of Contract No. 747 for the year ended 31st December, 2010

The work on Contract No. 747 was commenced on 1st January 2010. Materials costing Kshs. 170,000 were sent to the site of the contract but those of Kshs. 6,000 were destroyed in an accident. Wages of Kshs. 180,000 were paid during the year. Plant costing Kshs. 50,000 was used on the contract all through the year. Plant with a cost of Kshs. 200,000 was used from 1st January to 30th September and was then returned to the stores. Materials of the cost of Kshs. 4,000 were at site on 31st December, 2010.
The contract was for Kshs. 600,000 and the contractee pays 75% of the work certified. Work certified was 80% of the total contract work at the end of 2010. Uncertified work was estimated at Kshs. 15,000 on 31st December, 2010.

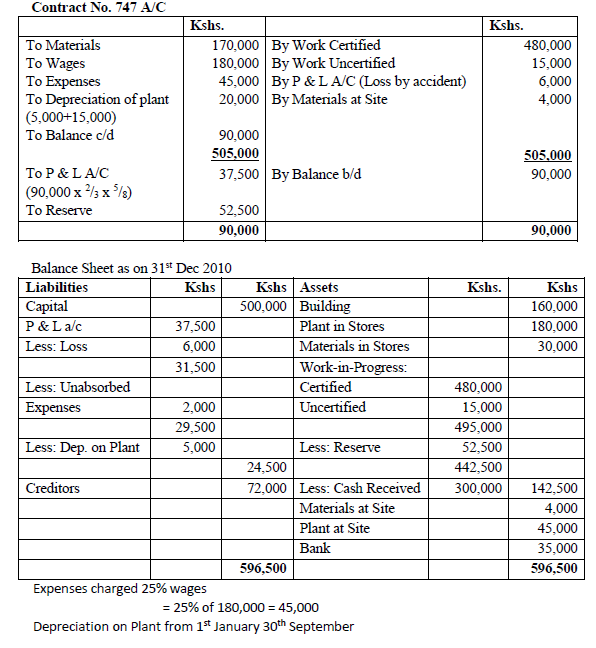

Expenses are charged to the contract at 25% of wages. Plant is to be depreciated at 10% for the entire year. Prepare Contract no. 747 Account for the year 2010 and make out the Balance Sheet as on 31st December 2010 in the books of premier Construction Co.



Answers


Wilfred
Wilfykil answered the question on April 16, 2019 at 06:11


Next: Read the extract below and answer the questions that follow.
Previous: Answer the following questions from the extract given below.

View More Cost Accounting Questions and Answers | Return to Questions Index


Exams With Marking Schemes

Related Questions
