AB undertook a contract for Kshs. 1,500,000 on an arrangement that 80% of the value of the work done as certified by the engineer of...



AB undertook a contract for Kshs. 1,500,000 on an arrangement that 80% of the value of the work done as certified by the engineer of the contractee should be paid immediately and that the remaining 20% be retained until the contract was completed.
In 2005, the amount expected was materials Kshs. 180,000, wages Kshs. 170,000, carriage Kshs.600, 000, cartage Kshs 1,000 sundry expenses Kshs. 3,000. The work was certified for Kshs.375, 000 and 80% of this was paid as agreed.
In 2006 the amount spent were: materials Kshs. 220,000, wages Kshs. 230,000, carriage Kshs. 23,000, cartage Kshs. 2000 sundry expenses Kshs. 4,000, ¾ of the contract was certified as done by 31st Dec. and 80% of this was received accordingly. The value of work uncertified was ascertained at Kshs. 20,000.

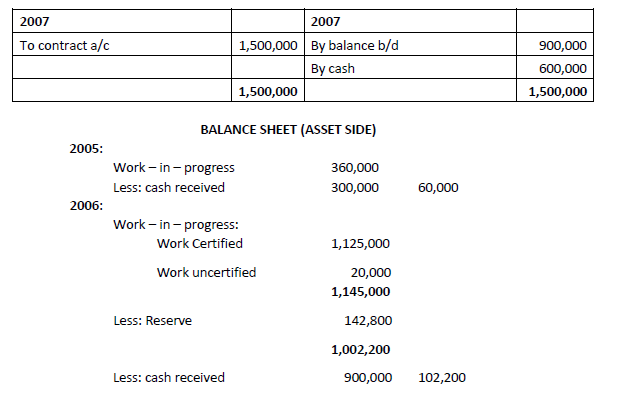

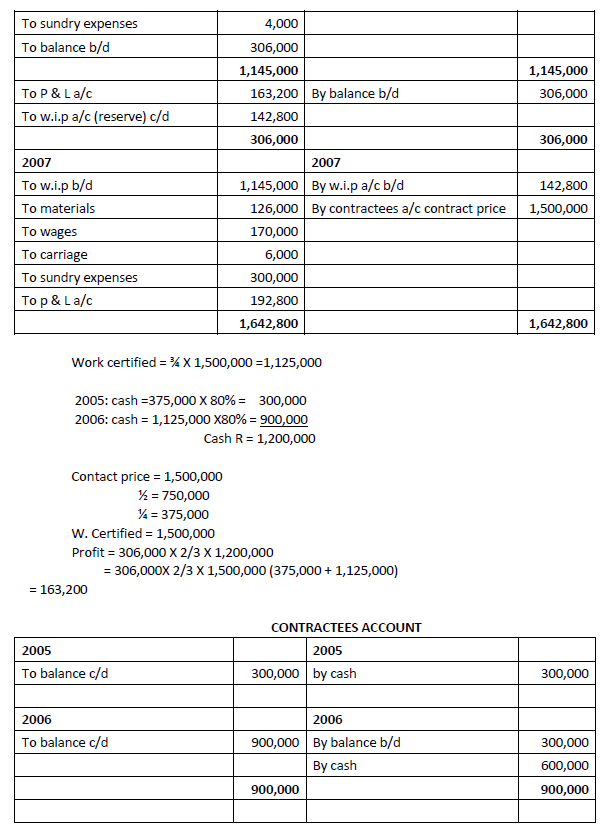

In 2007, the amount spent was: materials Kshs. 126,000, wages Kshs.170, 000, carriage Kshs. 6,000, sundry expenses Kshs.3, 000 and on 30th June, the whole contract was completed. Prepare contract account, contractees account and extract balance sheet (only asset side) as would appear each of this year in the books of the contractor assuming that the balance due to him was received on completion of the contract.



Answers


Wilfred
Wilfykil answered the question on April 16, 2019 at 06:23
