Crystal Construction Limited engaged in contract works has the following Trial Balance on 31st December 1975

Crystal Construction Limited engaged in contract works has the following Trial Balance on 31st December 1975

Contract No. 707 having a contract price of Rs. 240,000 was begun on 1st January, 1975 and contractee pays 80% of the work completed and certified. The cost of work done since certification is estimated to be Rs. 1,600. After the above Trial Balance was extracted on 31st December 1975, plant costing Rs. 3,200 was returned to the stores and materials at site on that date were valued at Rs. 3,000. Provision is to be made for sub standard costs amounting to Rs. 600 incurred in contract No. 707 and for depreciation of all Plant and Tools @ 12½% on cost.

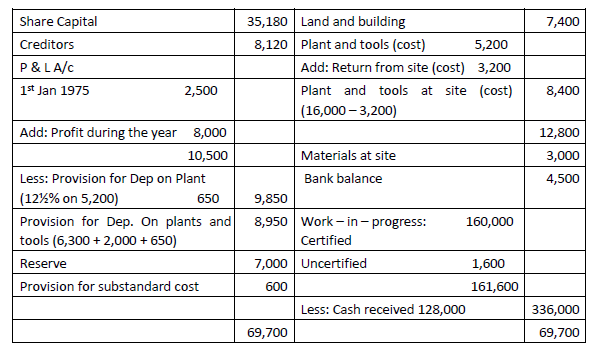

Prepare Contract No. 707 Account showing the computation of profit, if any which credit may properly be taken in 1975 and prepare the Balance Sheet for the construction company on 31st December 1975.

Answers

Wilfred
