The following are the projected monthly working requirements of Tayari Ltd. for the year ending 31 December 2008.



The following are the projected monthly working requirements of Tayari Ltd. for the year ending 31 December 2008.
The expected cost of short term funds is 20% while that of long term funds is 25%.
Ignore taxation.
Required:

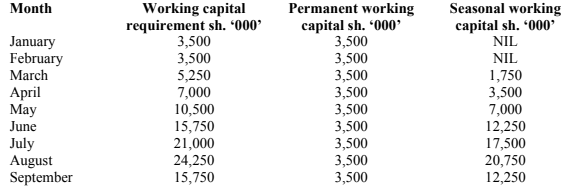

i) A schedule showing the amount of permanent and seasonal working capital requirements for
each month.
ii) Average amount of long term and short term finance that would be required monthly.

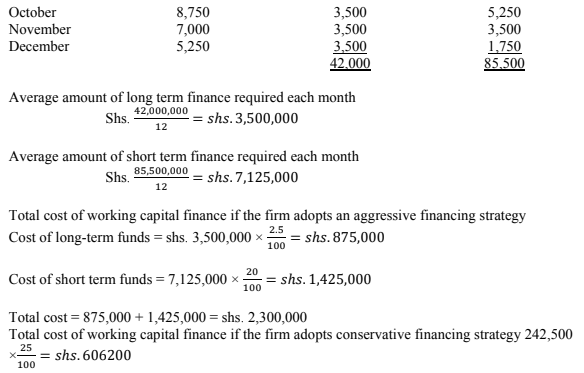

iii) Total cost of working capital finance if the firm adopts an aggressive strategy.
iv) The total cost of working capital finance if the firm adopts a conservative finance strategy.



Answers


Kavungya
Kavungya answered the question on April 28, 2022 at 09:19


Next: Fanaka Ltd. a large multi- national company is in the process of determining the optimal cash balance for the year ending 31 December 2009. The management of...
Previous: The following information was extracted from the books of Changa Ltd. at the end of the financial year ended 31 October 2006 and 2007.

View More CPA Financial Management Questions and Answers | Return to Questions Index


Learn High School English on YouTube

Related Questions
